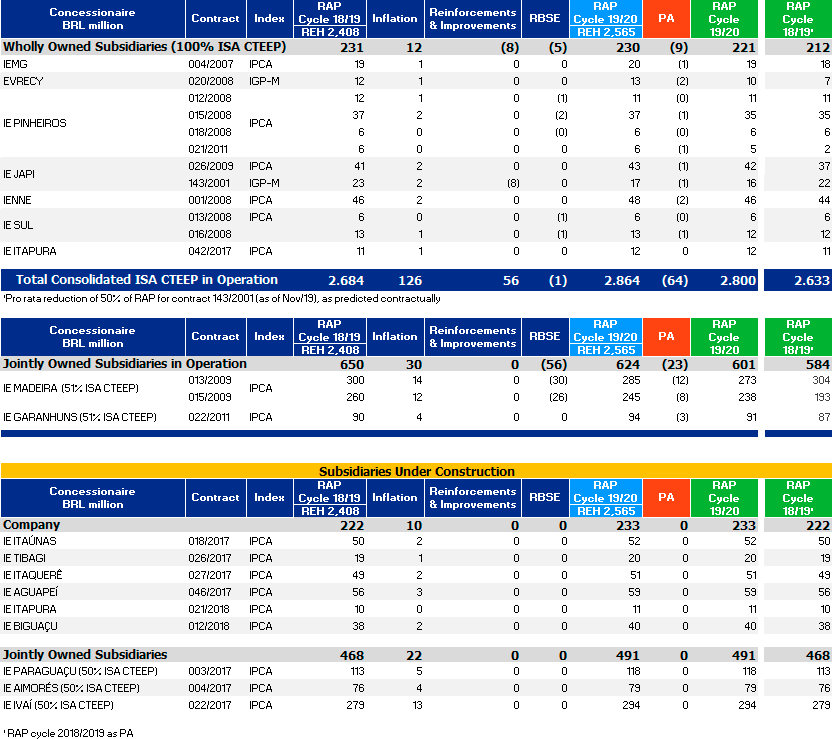

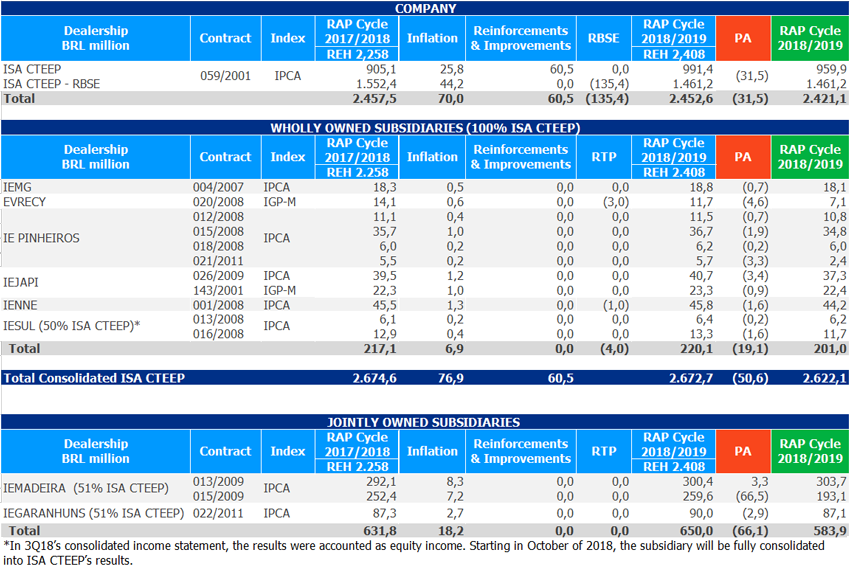

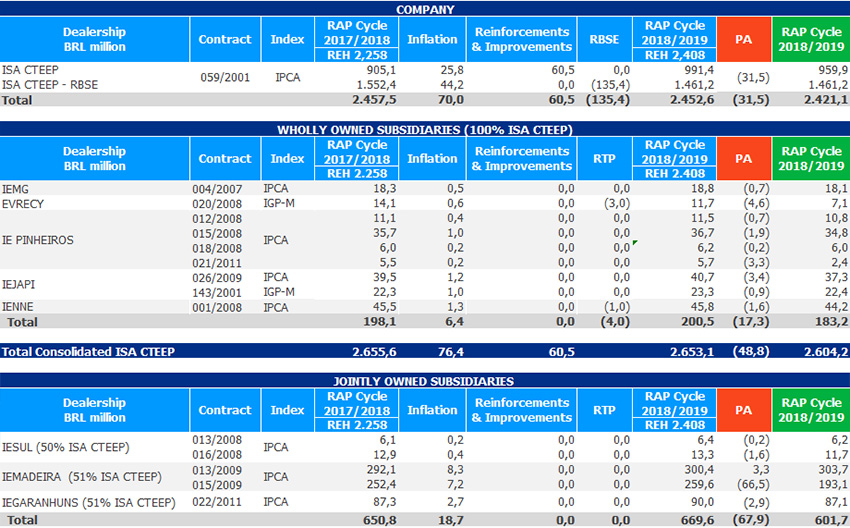

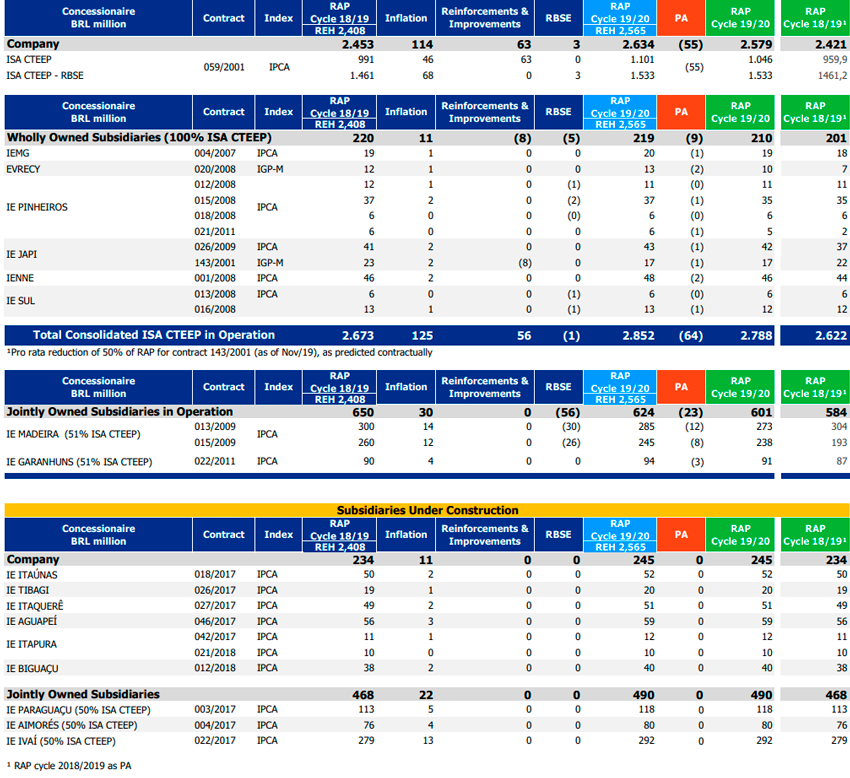

ISA CTEEP’s corporate structure includes its subsidiaries 100% and non-consolidated subsidiaries as shown below:



  Contract Deadline
(years)
Expiration Operational Status Next Tariff Review RAP
Cycle 2020/20211
(BRLmillion)
RAP  ISA CTEEP Cycle 2020/2021 (BRLmillion) Adjustment Index Share
(%)
Consolidation Transmission lines (km) Substations (MVA) Voltage (kV)
ISA CTEEP 059/2001 30 31/12/2042 Operational 2023 2.336 2.336 IPCA ISA CTEEP  100% Fully consolidated 14.631 50.057 440, 345, 230, 138, 88, 69 and 16 (synchronous compensators)
IE Madeira 013/2009
015/2009
30 25/02/2039 Operational 2024 311
267
158
136
IPCA ISA  CTEEP 51% / Furnas 24,5% / Chesf 24,5% Equity equivalence
Equity equivalence
2.385 7.464 600 CC
IE Ivaí 022/2017 30 11/08/2047 Under Constrution 2023 324 162 IPCA ISA CTEEP 50% / TAESA 50% Equity equivalence 600 2.988 500 e 230
PBTE 012/2016 30 21/11/2046 Operational 2022 180 180 IPCA ISA CTEEP  100% Fully consolidated 15 N/A 345
IE Paraguaçu 003/2017 30 10/02/2047 Under Constrution 2022 130 65 IPCA ISA CTEEP 50% / TAESA 50% Equity equivalence 338 N/A 500
IE Garanhuns 022/2011 30 09/12/2041 Operational 2022 100 51 IPCA ISA CTEEP 51% / Chesf 49% Equity equivalence 633 2.100 500 e 230
Aimorés 004/2017 30 10/02/2047 Under Constrution 2022 87 44 IPCA ISA CTEEP 50% / TAESA 50% Equity equivalence 208 N/A 500
IE Pinheiros 012/2008
015/2008
018/2008
021/2011
30 15/10/2038
09/12/2041
Operational 2024
2022
12
44
6
7
12
44
6
7
IPCA ISA CTEEP 100% Fully consolidated
Fully consolidated
Fully consolidated
Fully consolidated
1 4.500 345
Riacho Grande 05/2021 30 31/03/2051 Under Constrution 2025 68 68 IPCA ISA CTEEP  100% Fully consolidated 31 800 345
Serra do Japi 143/2001
026/2009
30 20/12/2031
18/11/2039
Operational N/A
2020
18
47
18
47
IGPM
IPCA

ISA CTEEP 100% Fully consolidated
Fully consolidated
137 2.000 230
IE Itaúnas 018/2017 30 10/02/2047 Under Constrution 2022 58 58 IPCA ISA CTEEP 100% Fully consolidated 79 1.350 345
IENNE 001/2008 30 16/03/2038 Operational 2023 58 58 IPCA ISA CTEEP 100% Fully consolidated 710 N/A 500
IEMG 004/2007
07/2020
30 23/04/2037
20/03/2050
Operational
Under Constrution
2022
2025
22
36
22
36
IPCA ISA CTEEP 100% Fully consolidated 173
172
N/A
1.600
500
345
IE Aguapeí 046/2017 30 11/08/2047 Operational 2023 55 55 IPCA ISA CTEEP 100% Fully consolidated N/A 1.400 It has no transmission line. Bay voltage: 440. 138 and 13.8 (synchronous compensators)
IE Itaquerê 027/2017 30 11/08/2047 Operational 2023 53 53 IPCA ISA CTEEP 100% Fully consolidated N/A 900 It has no transmission line. Bay voltage: 500 and 13.8 (synchronous compensators)
Evrecy 020/2008
01/2020
30 17/07/2025
20/03/2050
Operational
Under Constrution
2021
2025
18
42
18
42
IGPM
IPCA
ISA CTEEP 100% Fully consolidated
Fully consolidated
163
169
450
2.691
230
230
IE Tibagi 026/2017
006/2020
30 11/08/2047
20/03/2050
Operational
Under Constrution
2023
2025
11
6
11
6
IPCA ISA CTEEP 100% Fully consolidated
Fully consolidated
17
37
500
N/A
230
230
IE Biguaçu 013/2008 30 15/10/2038 Under Constrution 2024 45 45 IPCA ISA CTEEP 100% Fully consolidated 27 300 230
IE Sul 016/2008
012/2018
30 15/10/2038 Operational 2024 22 22 IPCA ISA CTEEP 100% Fully consolidated
Fully consolidated
179 900 230
IE Itapura 042/2017
021/2018
30 11/08/2047
21/09/2048
Operational
Under Constrution
2023
2024
13
12
13
12
IPCA ISA CTEEP 100% Fully consolidated
Fully consolidated
N/A
5
250
1.200
It has no transmission line. Bay voltage: 440 and 13.8 (synchronous compensators)
500 and 230
Total           4.387 3.783       20.710 81.450

Note: 1 RAP consider 100% of the project | 2 IE Tibagi's RAP does not consider adjustment resulting from the contractual amendment (-13.5%), approved by ANEEL's Board on 10/26/20

Click here to download the spreadsheet

Updated on August 18, 2021.
